ARTICLE
18 August 2025

Special BESS Grid Connection Scheme

BL
Bernitsas Law

Contributor

Bernitsas Law is a market leader in the provision of commercial law services in Greece and one of the largest firms in the country. We count industry frontrunners, listed and private companies, supranational, global and national entities and corporations, and small and medium sized enterprises from all the major industry sectors among our clients.

Earlier this month, following a delay of more than one year, a critical development for the Greek energy market took place. The Ministry of Environment and Energy introduced a special grid connection priority framework...
Greece Energy and Natural Resources

Our Energy Law Briefing Special Edition provides an overview of the Special BESS Grid Connection Scheme:

A. Introduction
B. Project Grouping
C. Eligibility Requirements
D. Anti-Concentration Rules
E. Development and Operational Requirements
F. Penalties
G. Application Process
H. Financial Robustness

A. Introduction
1. Earlier this month, following a delay of more than one year, a critical development for the Greek energy market took place. The Ministry of Environment and Energy introduced a special grid connection priority framework for merchant storage projects, which had initially been anticipated by Law 5151/20241.
2. Based on a new Ministerial Decision2, standalone Battery Energy Storage Systems (BESS) projects that have not been awarded investment aid or operating support through the tender procedures of the Regulatory Authority for Energy, Waste and Water (RAEWW) will enjoy special benefits in the race for Final Grid Connection Offers (FGCOs) (the Special BESS Grid Connection Scheme).
3. The Special BESS Grid Connection Scheme applies to BESS projects set to be connected both to the Transmission System operated by IPTO and to the Distribution Network operated by HEDNO.
4. The Special BESS Grid Connection Scheme did not directly amend the Grid Connection Priority Framework and the Industrial and Agricultural PPA Grid Connection Priority Framework introduced in 2022 and 2024 respectively. However it does affect the existing order of priority by effectively granting merchant BESS projects a significant head-start compared to other categories.
5. Applications for eligible projects will be evaluated by the Grid Operator (IPTO or HEDNO) in parallel with:
a. projects falling under the Industrial and Agricultural PPA Grid Connection Priority Framework;
b. hybrid projects located in non-interconnected islands and Crete; and
c. storage projects that have already secured operating support through the RAEWW tender processes.
6. This new Ministerial Decision defines project groups, capacity limits, eligibility criteria, anti-concentration and prioritization rules, regulates the application process and technical requirements, and sets penalties imposed for non-compliance.
7. After the evaluation of applications based on the set criteria and process, a Ministerial Decision is expected to establish the selection order of eligible merchant BESS projects favored by the fast-track scheme.

B. Project Grouping
1. Eligible BESS projects fall into two main categories of ESMIE and EDDIE Project Groups.

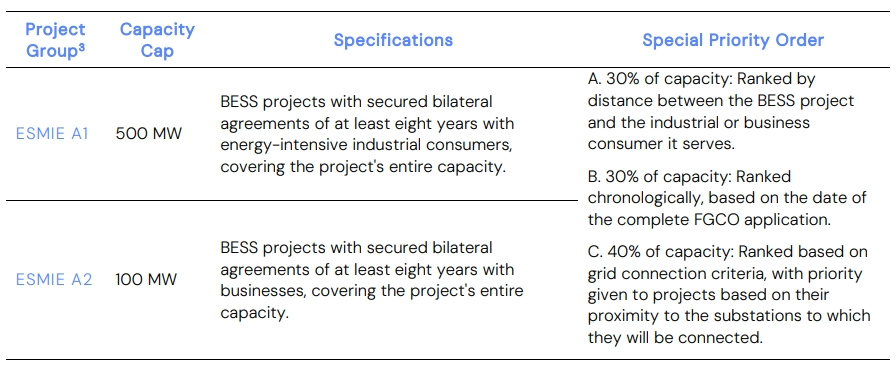

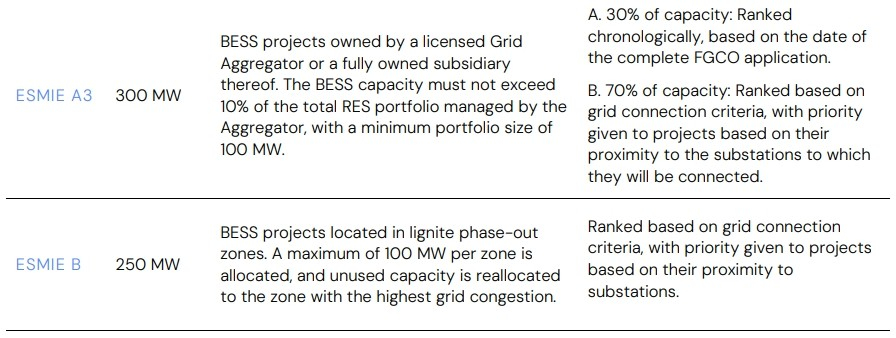

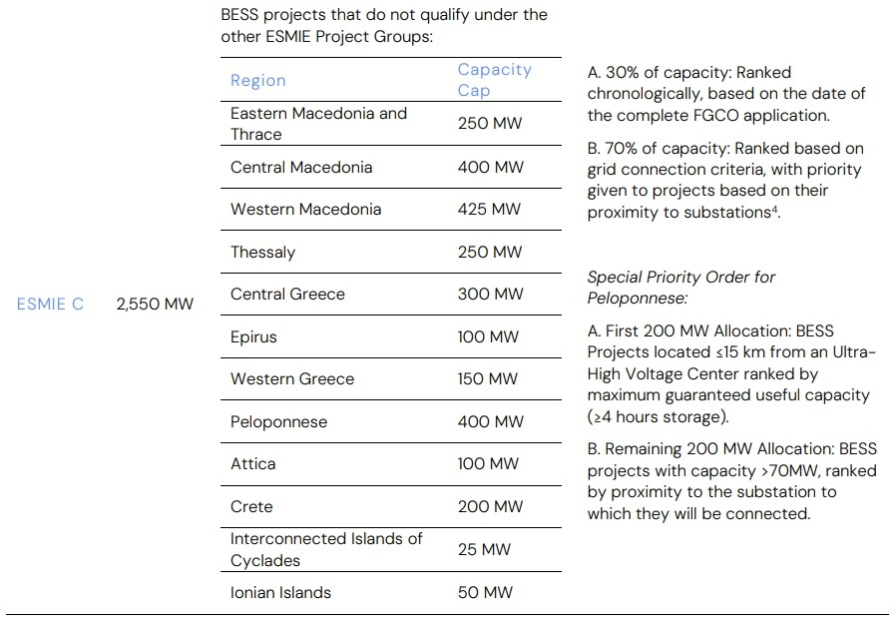

2. ESMIE Project Groups include eligible projects with a capacity of >10MW connected to the Transmission System:

3. EDDIE Project Groups: Eligible projects with capacity ≤10MW connected to the Distribution Network:

C. Eligibility Requirements
1. To qualify for the Special BESS Grid Connection Scheme, merchant BESS projects must meet specific criteria, including:
a. a complete application for an FGCO must have been submitted after 4 July 2022;
b. the project owner must have secured external financing (or at least pre-approval) or demonstrate sufficient equity to fully fund the development of the BESS project at the time of submission of the application; the reference amount of the construction cost is €200/kWh;
c. the BESS project has a maximum injection capacity of at least 0.5 MW and a usable storage duration of at least two hours;
d. an FGCO has been issued for the BESS project, whether as a standalone system, an addition to an RES project sharing a common connection point, or through the conversion of conventional power plants or fossil fuel generation licenses into storage projects;
e. the investor must demonstrate that they have robust land rights over the project site; and
f. the BESS project must meet several technical and operational requirements, while the investor must take out at least the minimum insurance policies and ensure proper decommissioning and equipment recycling.

D. Anti-Concentration Measures
1. The new Ministerial Decision limits the capacity per investor that can benefit under the Special BESS Grid Connection Scheme to discourage market concentration. Each project owner may directly or indirectly hold standalone BESS projects to be connected to the:
a. Transmission System with an aggregate capacity of < 250 MW; and
b. Distribution Network with an aggregate capacity < 50 MW.
Additionally a cumulative market cap of 500 MW per project owner applies to all BESS projects (standalone or RES-combined6) until 2029.
2. In addition to the above general caps, for projects qualifying under groups:
a. ESMIE Α1 and ESMIE Α3, a special limit of 100 MW of BESS projects has been set; and
b. ESMIE Α2 and EDDIE D investors can directly or indirectly connect up to 50 MW of BESS projects.

E. Financial Robustness

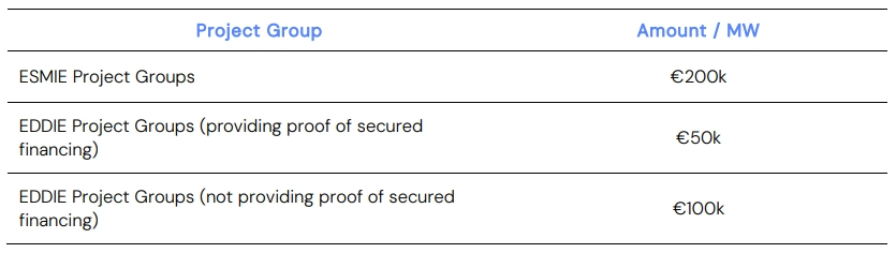

1. The application must be accompanied by a letter of guarantee with a minimum validity of two years (the Application Bond), calculated as follows:

2. Upon issuance of the FGCO, the Application Bond must be replaced with a letter of guarantee for the performance of the project of the same amounts (the Performance Bond). The Performance Bond is reduced to half of the initial amount after three years of operation and is returned to the interested party after 6 years.

F. Development and Operational Requirements
1. BESS projects securing grid connection under the Special BESS Grid Connection Scheme must submit a Declaration of Readiness within 18 months of FGCO acceptance and will be subject to curtailment measures.

G. Penalties
1. If a project fails to comply with the Special BESS Grid Connection Scheme requirements, including timely electrification, the Application Bond or the Performance Bond will be forfeited.
2. The relevant Grid Operator will also suspend the project's grid connection until full compliance is achieved.

H. Application Deadlines

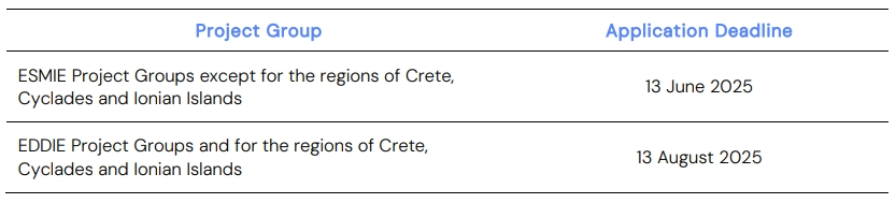

1. To qualify under the Special BESS Grid Connection Scheme, project owners must submit an application within the following deadlines:

Footnotes

1 The special framework for the grid connection of merchant storage projects was established by virtue of Article 41 of Law 5151/2024, which amended Law 4685/2020 by adding new Article 11D.

2 ΥΠΕΝ/ΓΔΕ/28255/1143/2025, Government Gazette B' 1248/13.3.2025.

3 IPTO will evaluate the applications for each Project Group in the following order: a) ESMIE B, b) ESMIE C, c) ESMIE A1, d) ESMIE A2 and e) ESMIE A3.

4 Refers to Ultra-High Voltage Centers or Substations that are either currently operating, under construction, or those with a Grid Connection Agreement in place.

5 The project's maximum capacity must not exceed the business's peak annual consumption, as recorded in 2024 or the most recent full calendar year.

6 Excluding RES projects with integrated BESS that cannot absorb power from the grid.

The content of this article is intended to provide a general guide to the subject matter. Specialist advice should be sought about your specific circumstances.
